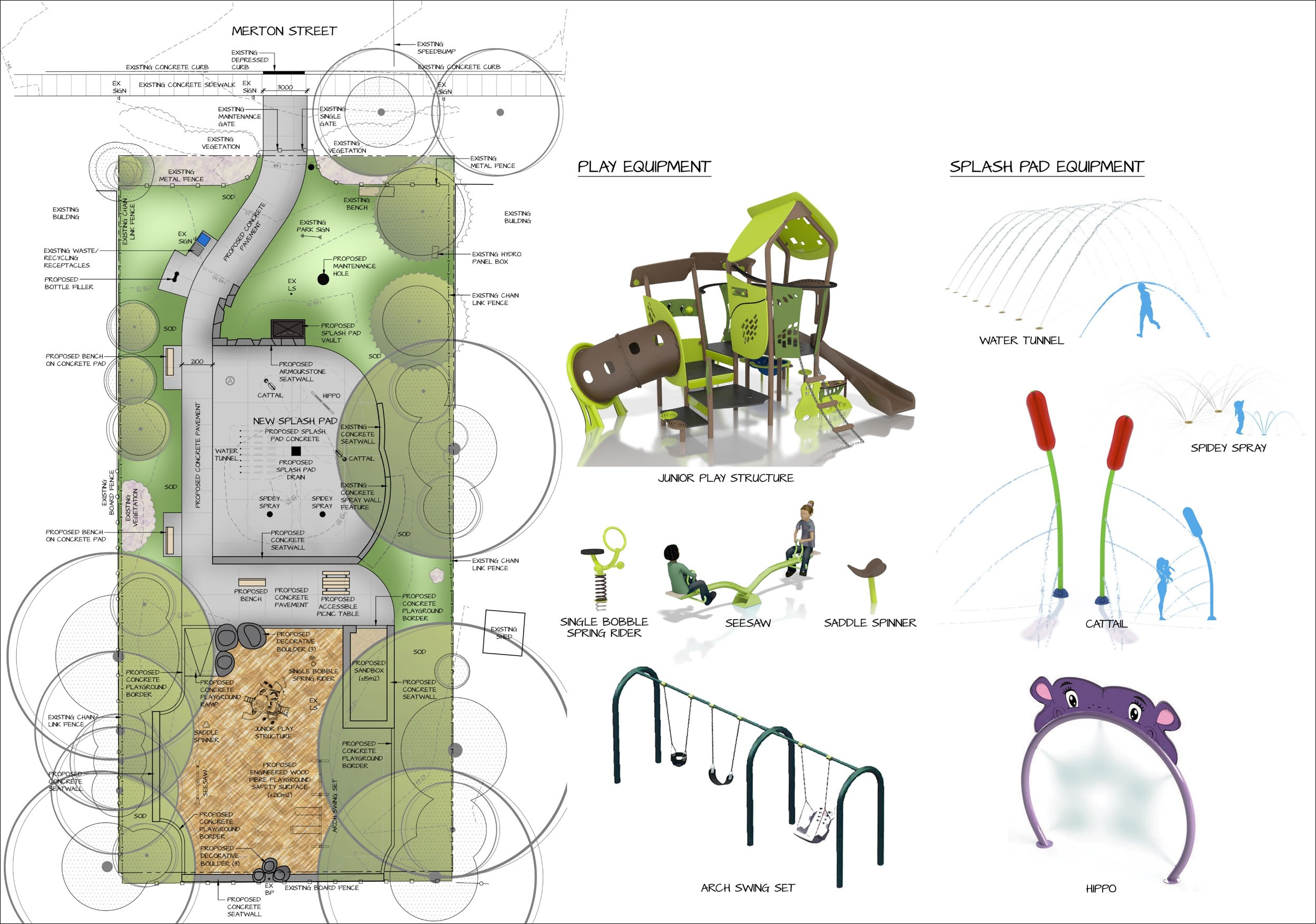

For your information and review, here are the final illustrative panels of the exciting improvements to Sharon, Lois & Bram Playground at June Rowlands Park. Special thanks to Lesley Stoyan, the Communities in Action Group, Sharon Hampson and Bram Morrison for their participation in our design team, Dan Connolly and City Parks staff and everyone who contributed to community consultation meeting I hosted on April 3rd at Greenwood College School.


If construction progresses as planned, and without any unforeseen impediments such an inclement weather, work on the additions to our playground should begin sometime this fall (also to avoid impacting the enjoyment of our park during the summer season).


Best Regards,


Josh





City Hall and Community Update for March 31, 2017

Groundbreaking Tenant Protection Legislation Passes Final Hurdle

As Chair of the Tenants Issues Committee, I am very pleased to report that my colleagues supported our new Tenant Protection by-law to provide much needed protection for Toronto renters. The provisions in the by-law will be in force by July of this year.

This success was the result of years of hard work with local tenant advocates and city-wide organizations, including the Federation of Metro Toronto Tenants’ Associations, ACORN, Advocacy Centre for Tenants Ontario, and community legal clinics.

At present, far too many renters live in sub-standard housing.  The City’s Multi Residential Audit Building (MRAB) program has found over 58,000 deficiencies in approximately 1000 buildings since Building Audits began.  Leaking roofs, stained carpets, non-functioning elevators, and pest infestations are far too common.  And these violations are mostly from just the shared areas in buildings and don’t capture the serious problems tenants face inside their units.

Some landlords have ignored City orders to fix their properties for years with little consequence; they treat the small fines as the cost of doing business, drag out performing the repairs through court appeals, and are even granted time extensions.

The system certainly doesn’t give tenants the same leniency when their rent is due.

This comprehensive new by-law includes several motions I moved to address some of these concerns, including:
  • A “Rentsafe” rating program for buildings modelled off of the “Dinesafe” program for restaurants that requires landlords to post a colour-coded sign that displays the City's rating in a prominent, publicly identifiable location, along with posting the same information on the City's website
  • Requesting that the Province grant the City the power to fine landlords for property standards violations
  • Establishing guidelines for when the Property Standards Committee can grant time extensions on work orders for violations and to limit those criteria to situations that are only extraordinary circumstances
  • Developing standard operating procedures for City enforcement officers which provide targeted timelines by violation category to bring landlords into compliance with City by-laws from the date an order is issued, and make the standards available to the public on the City website
  • Ensuring that landlords will not be able to rent vacant units if they have outstanding property orders in the building for vital services such as heat or water
These measures, and many others contained in the program, were the result of extensive consultation with tenants across the city.

For more information on this ground-breaking legislation, please see this article.

Council Ignores Evidence and Chooses 1-Stop Subway Over 24-Stop LRT Network for Scarborough

As many of you have heard by now, Council has opted to continue work toward a 1-stop extension of the Bloor-Danforth subway to the Scarborough Town Centre instead of a 2-line, 24-stop network. I wrote extensively about the options in my previous newsletter to you.

It is unfortunate that, yet again, Council decided to not ask for relevant and important information by voting against my motion to have Staff finally provide a Business Case Analysis comparing the 1-stop subway with a 7-stop LRT in the McCowan corridor. This is especially disappointing in light of the answers to my questions on transit options for Scarborough ahead of the vote which, among other things, stated that:
  • The briefing note provided by the TTC in 2016 claiming that the cost of the LRT was the same as the subway was based on incorrect assumptions
  • Funding sources and amounts for the 1-stop subway extension have not yet been finalized
  • The LRT plan is at a far more advanced design stage than the 1-stop subway
In addition, a new study released before the vote found that most Scarborough residents will spend more time on the bus with the 1-stop subway plan.

Despite this setback, I will continue to advocate for honest and evidence-based transit. For more information on what this vote means going forward, please see this article.

Unprecedented Meeting on Tenants and Housing Affordability Next Week

On Monday, April 3 I will be co-hosting an unprecedented joint meeting(s) of the Tenant Issues Committee, which I Chair, and the Affordable Housing Committee with my colleague, Councillor Ana Bailao.

Toronto's rental housing market has become increasingly unaffordable for many people.
The challenges of finding and keeping a decent and affordable place to live are affecting people across the rental spectrum in all areas of the city, including Midtown.

Rents are rapidly rising beyond the rate of inflation and, on the turnover from one tenant to the next, units newly on the market are drawing bidding wars. Due to historically low vacancy rates and a lack of new purpose-built rental supply, more and more residents are finding themselves precariously housed by renting condominiums.

Despite the ongoing construction of new condominiums, there remains a critical shortage of homes that people can afford. As a result of market pressures and a lack of protection for any rental unit built after 1991, some tenants in condominiums have recently reported annual rent increases between 10% and 50%.

Residents in purpose-built rental buildings that supposedly have protection from rents rising above inflation are also at-risk. Landlords are allowed to increase rents substantially for basic maintenance, including balcony replacements and new boilers, due to unfair provisions in the provincial Residential Tenancies Act.

This meeting will look at housing affordability in a holistic manner and request the provincial government and City Staff to move forward with concrete measures to help ensure that all Torontonians have access to a safe, clean, and healthy home.

The meeting will take place at 3pm in Committee Room 2 on the 2nd floor of City Hall.

Proposal to Increase Fines for Speeding in School Zones

I was very pleased to support a motion by Councillors Mark Grimes and Mike Layton to request the Province to allow the City the ability to double fines for speeding in designated school zones. This is an important issue in our community and I will be advocating for this important measure as it moves to the Ontario government.

Community Meeting: Next Improvements to June Rowlands Park and Sharon, Lois & Bram Playground

On Monday, April 3 at 7pm, please join me to discuss your vision for an improved and expanded Sharon, Lois & Bram Playground and other enhancements at June Rowlands (Davisville) Park. City staff from Parks, Forestry & Recreation will be in attendance to present design concepts and receive your feedback.

The meeting location is Greenwood College (443 Mount Pleasant Road), Room 174. I hope to see you there!

To view the event flyer, please click here.


SAVE THE DATE: Councillor Josh Matlow's Community Environment Day

On Thursday, June 1 from 4-8pm, I will be hosting my annual Community Environment Day. The event will take place in the parking lot of North Toronto Memorial Arena (174 Orchard View Blvd). Please drop off any unwanted art supplies, books, toys, and used sports equipment. Facilities will be available to dispose of computers and other hazardous household waste, or even replace your damaged green bin.


Toronto-St. Paul’s Summit: Working Together for a Better St. Paul’s

Please join me and my colleagues representing all levels of government at this year's St. Paul's Summit on Sunday, May 7 at Christ Church Deer Park (1570 Yonge Street), 3-5pm.

Together with the St. Paul's community we will be talking about key issues affecting our country, province, city, school boards and neighbourhoods.

I am honoured to be joining federal MP, Dr. Carolyn Bennett, provincial MPP, Dr.Eric Hoskins, my local colleagues at City Hall and school trustees in this important conversation with our residents.


Deer Park Residents Group Annual General Meeting

Please join me for the Deer Park Residents Group (DPRG) Annual General Meeting on Tuesday, June 6 at Calvin Presbyterian Church (26 Delisle Avenue). The membership desk will open at 6:30pm and the meeting will commence at 7pm.

The annual meeting of the DPRG is an opportunity for residents of our neighbourhood to learn about activities during the past year. The agenda will include a summary of actions taken by the DPRG, events in our district and an election of members of the Board for the coming year. I will be speaking to attendees about developments in Ward 22 and beyond that have an impact on all of us. Any persons attending who are not already members of the DPRG will be encouraged to join.

The DPRG welcomes members who have an interest in participating in its activities and serving on the Board. Please feel welcome to email  This e-mail address is being protected from spambots. You need JavaScript enabled to view it for more information.

South Eglinton Ratepayers' and Residents' Association Annual General Meeting

The South Eglinton Ratepayers’ and Residents’ Association (SERRA) is constituted for the purpose of furthering and protecting the common interests of its members relating to real estate, zoning, municipal planning and any other matter touching on or relating to real property within the membership area, bounded by Yonge Street, Bayview Avenue, Eglinton Avenue and Merton Street.

SERRA will be holding its AGM this year at 7pm on Monday, May 8 at Greenwood College School (443 Mount Pleasant Road). I hope to see you there!

Clean Toronto Together Registration is Now Open

It's time for some spring cleaning! Gather your friends, neighbours, co-workers and classmates to clean a park, laneway or any other space that needs your help. Friday, April 21 is the Corporate & School 20-Minute Makeover; Saturday, April 22 and Sunday, April 23 are the Community Cleanup Days.

Registration is now open. Individuals, community groups, schools and businesses can register their cleanup events online or by calling 311. Registration helps the City arrange for special litter and recycling pickups and helps to reduce duplicate cleanups. Learn more and find out when and where to get free GLAD® garbage and recycling bags for your cleanup online or by calling 311.

To learn more and to register your event, please click here.


If you are planning to hold a community clean-up, please let me know and I'd be happy to drop by and help out!

Celebrating National Caregiver Day

Twenty-nine percent of Canadians and Torontonians are family caregivers to someone in need. The majority of them are seniors. On January 31, 2017 City Council passed a motion to recognize Family Caregiver Day annually on April 4.

In recognition of Family Caregiver Day we will be holding an event in the Council Chamber at City Hall, co-hosted by City staff involved in the Toronto Seniors Strategy, the Toronto Seniors Forum, ENRICHES and twelve other stakeholder organizations, to recognize the valuable contribution of family caregivers to our community and to express our support.

Family caregivers often assume this role with no training or additional resources and are facing challenging and stressful situations on a daily basis. The latest report of the ‘Change Foundation’ suggests that the majority of caregivers succumb to physical and psychological illness as a result of their caregiving responsibilities. Despite that, they are often not recognized for their role and are not perceived as a population in need of support in the health care system and the community at large.

This event promises to be a wonderful opportunity for Toronto to come together in support of this often invisible and vulnerable group of individuals that is such a crucial component to the well-being of our Toronto community. As the City's Seniors Advocate, I am delighted to be speaking to attendees at 1pm on Tuesday, April 4.

For full event details, please click here.

Toronto Seniors Strategy 2.0: Have Your Say!

In my capacity as the City's Seniors Advocate, I'm actively working with City staff and community partners to develop the next phase of the Toronto Seniors Strategy, to improve City services for older Torontonians and make Toronto a more age-friendly city. We would also love to hear from you! I encourage you to participate in our online survey by April 15.

Please click here to access the questionnaire.

Toronto Seniors Helpline

WoodGreen Community Services, Toronto Central CCAC, and Toronto Central LHIN are pleased to launch the Toronto Seniors Helpline (TSH)!

The Toronto Seniors Helpline is a single phone line that streamlines access to community, homecare and crisis services for seniors, their caregivers and their health care providers. Through this initiative, CNAP, Seniors Crisis Line and TC CCAC information and referral staff have unified as a single team with a shared focus on information and referral, supportive counseling and service navigation services. As a result, seniors will experience the ease of one access point, more streamlined care, and warm transfers to the services that best meet their needs. TSH is for seniors, caregivers, and health care professionals.

TSH can be reached at 416-217-2077. The number is TTY-compatible; interpretation services are available.

TSH is answered by certified staff who connect people to the care they need, including CCAC home care services, crisis outreach teams, and other services in our community that support seniors’ safety, health and well-being. The team is comprised of information and referral staff from the TC CCAC and WoodGreen staff, all of whom have been cross-trained in service offerings across the home and community sector, including crisis services.

Low Income Retirement Workshops at Toronto Public Library

Planning for Retirement on a Low Income workshops will be offered again this spring at 9 library branches in Toronto, thanks to generous funding from The Rotary Club of Toronto. The goal of this workshop is to provide low-income attendees, in plain language, with a complete picture of benefits available to them, explain how these benefits interact, and outline best strategies for long term retirement planning on a very limited income. John Stapleton, Metcalf Foundation Fellow and social policy expert, is the presenter.

The impact of the series cannot be overstated. Mainstream financial advice is in most cases, inappropriate and detrimental to low-income earners. For example, advising a low-income person to save within an RRSP, can be very bad advice as it reduces their Guaranteed Income Supplement. Simply put, this information is not readily available elsewhere, and fills a real need. The 9 workshops in the fall 2016 series attracted 523 attendees – mostly disadvantaged persons in need of any available assistance, or someone attending on their behalf.

North Toronto Memorial Community Centre Temporary Closure

The City is enhancing North Toronto Memorial Community Centre to improve facility operations and services to the community. The centre will close for state of good repair renovations in September 2017 for approximately 18 months. For more information, please click here.

While the community centre is located outside of my ward, many Ward 22 residents use the facility and will be impacted by this closure. I encourage you to attend an upcoming community meeting hosted by City staff to learn more about the renovations and program relocation. The meeting will be held at North Toronto Memorial Community Centre at 6:30pm on Wednesday, May 17.

Open Call for Jane's Walk Leaders

May 5th, 6th, & 7th Jane's Walk Festival

If you have a fun, informative, unusual way of looking at your neighbourhood, then Jane’s Walk wants you to host a walking conversation in your community!

Jane’s Walk is a global movement of free, community-led walking tours inspired by Jane Jacobs. The walks get people to explore their cities and connect with neighbours. Organizing a Jane’s Walk is easy. It simply involves planning a route, thinking through the stories, places, people and ideas you want to hear and talk about, and then posting it online atjaneswalk.org/toronto. Learn more at www.janeswalk.org.

Jane’s Walk is a great way to personally connect with with other residents, share stories of the neighborhood, and discuss important issues in your community. New walks are posted here every day.

City of Toronto's Proposed Stormwater Charge

Currently, stormwater management is being paid for from the water rate, which means the amount homeowners pay for stormwater management is based on how much water they use. The Stormwater Charge proposal is to remove the portion that homeowners currently pay for stormwater management (currently embedded in the water rate), and show it as a separate charge on the water bill. The water rate would decrease and the stormwater charge would be added. The amount paid for stormwater would be based on property size and the average amount of hard space on properties of a similar size.

More information is available at toronto.ca/stormwatercharge, including:
  • Full details and information about the proposed stormwater charge
  • An online survey to allow for public feedback
  • Examples of how the proposed stormwater charge could impact water bills
  • A full list of the categories and tiers for the proposed stormwater charge
  • A full listing of the public consultation dates and locations

Wheel-Trans Public Meetings: 10-Year Strategy Update and Next Steps

As a follow up to the public meetings held last summer, TTC will be hosting another round of consultations in April to update current and prospective customers on the Wheel-Trans 10-Year Strategy.

Participants will be provided details on the recently implemented Wheel-Trans eligibility and policy changes, as well as information on the Family of Services Pilot Program, Mobility Transfer Hubs and the proposed Community Bus Routes. The presentation will be followed by a Q&A period and an opportunity to provide input on each of these initiatives.

Details on the public meetings can be found on the TTC Wheel-Trans Public Consultations page.

Public Invited to Debate, Collaborate and Create as Consultation on City of Toronto's Long-Term Financial Plan Continues

The City of Toronto is launching Phase 2 of its public consultation on the renewal of its Long-Term Financial Plan. Information about the consultation, including background reports and engagement opportunities, a public workshop and an upcoming online survey, is available athttp://www.investinginTO.ca/. The public is also invited to participate in the conversation on social media, using the hashtag #InvestinginTO.

For the second phase of consultation, the City is inviting members of the public to City Hall for a conversation about how it makes decisions and balances priorities that have a long-term financial impact.

An interactive afternoon of workshops and discussions will be held at Toronto City Hall, 100 Queen St. W., on Saturday, April 22 at 1-5pm. The open house will begin at 12:30pm.

This is an opportunity for the public to:
  • debate how City Hall can balance both its books and its long-term priorities
  • collaborate with community organizations, other members of the public and the City
  • create a financial path that brings us closer to the city we want
More information about the workshops and discussions is available athttp://www.investinginTO.ca/. The workshops will be available via webcast for those who wish to participate online.  An online survey will also be open from April 22 to May 14.

The first consultation, which took place last fall, focused on how the City manages expenses, raises revenue and could maximize its assets. The City heard about the need to balance the priorities and budgets while also supporting the most vulnerable Torontonians. The public was also clear about keeping the City's commitments to innovation, economic health, infrastructure investments and the environment while finding ways to pay for them. The City also heard about the need for information that helps the public understand and contribute to the City's budgets, plans and decision making.

The findings from the consultation process will provide advice for Council and the City Manager as the City sets out to develop its Long-Term Financial Plan. The plan will guide financial decision-making over the long term and put Toronto on a path to financial sustainability. It will also help address structural financial issues as expenditures continue to rise faster than revenues, and help ensure that the City continues to run well, spends public money wisely and delivers the programs and services residents need and want over the long term.

44 Jackes Avenue Public Meeting

The City has received an application to amend the Zoning By-law to permit a new high-rise residential building in the northwest corner of a 1.26 hectare site with two existing high-rise rental apartment buildings. The new building is proposed to be 29-storeys high with a 4-storey podium base.

Please join me at 7pm on Thursday, April 13 in the Cameron Room at Yorkminster Park Baptist Church (1585 Yonge Street), for a meeting to discuss the proposed development. City Planning staff will be in attendance to answer any questions you may have.


390 Spadina Road Development Update

The South Forest Hill Residents Association (SFHRA) has asked that I share the following message with you regarding this inappropriate development proposal:

Forest Hill Village is Under Attack!

More than 60 local residents attended the pre-OMB hearing on March 1st forcing the OMB to move the proceedings to their largest room. South Forest Hill Residents Association (SFHRA) was well represented by lawyer, Peter Carey, who was successful in securing our "party" status at the OMB.

No date has been set for the OMB hearing itself.  Instead, a second pre-hearing date has been set for August 8th to review any revisions to the developer's plan and determine next steps.  In order to prepare for this meeting, SFHRA needs to hire their own experts to counter the aggressive and well-financed attack by the Armel Corporation and their partners.

We have our work cut out for us!  Did you know the OMB rules 64% of the time against communities and only 36% in favour of communities?  The community can only win this with the support of each member of the community.

Fundraising has begun with a goal to raise $65,000 to prevent the destruction of the Village.  You can help by donating generously:

1. ONLINE- click on the link which will take you to our GoFundMe page:
http://www.gofundme.com/save-forest-hill-village
OR
2. Drop off your cheque made out to South Forest Hill Residents Association at 350 Lonsdale Rd (Attention: Mona Kornberg). There's a 24 hour Concierge.

For further information or to join the fight, email the SFHRA at  This e-mail address is being protected from spambots. You need JavaScript enabled to view it or visit us on Facebook!

* South Forest Hill Residents Association is an incorporated non-profit organization governed by a volunteer Board of Directors

Development Proposals in Ward 22

To ensure you are informed and engaged about development proposals being proposed for sites near your neighbourhood, I've created an interactive webpage

My webpage listing all the proposed developments in Ward 22 has recently been updated to reflect current development applications and, as always, contains locations, staff reports and public meeting notices. Additionally, the map now shows the boundaries of the Urban Growth Centre surrounding Yonge and Eglinton, as well as the designated Avenues (portions of Eglinton Avenue West, St. Clair Avenue West, Yonge Street, Mt. Pleasant Road and Bayview Avenue). These are all areas where the Province is directing growth. Clicking on any of them will provide links to more information about the ward's Avenues/Urban Growth Centre, as well as links to the City's Official Plan and local secondary plans.

The OMB is a quasi-judicial, un-elected and un-accountable provincial body that has the final say on all planning decisions in the province of Ontario. The tribunal's powers to overrule decisions made by our elected municipal representatives are anti-democratic and often lead to planning decisions that far too often support the interests of the development industry over those of our communities and our city's official plan. To read more about the OMB and my advocacy to free Toronto from its purview, please click here.



It's Time to Move Forward Now with an Honest and Fact-Based Transit Plan to Serve Scarborough Residents

Dear Residents,

A bad deal for Scarborough residents keeps getting worse. The cost of the 1-stop subway proposal has risen to $3.346 billion, a 50% increase from when the project was first announced in early 2016. As the cost is going up, Staff are projecting that fewer people will actually want to use the new line. The new report states that the subway will only attract 2,300 new daily riders. That means that the City would be paying approximately $1.45 million for every new rider that the stop gains.

The competing plans that will be debated at Council next week are the same as when I wrote to you about it in a newsletter last July. A 1-stop subway to the Scarborough Town Centre (STC), as shown below:



Or, for approximately the same City funding, we can choose instead to build 2 LRT lines with 24 stops. One line would have 7 stops using the existing RT corridor to link STC and Centennial College to Kennedy Station. This project is part of the signed Metrolinx Master Agreement, and would be mostly funded by the provincial government. Then, with money saved by moving forward now with the approved LRT, Council could fund a new 17-stop extension of the Eglinton Crosstown through Kennedy, serving Kingston Rd, UofT Scarborough, and several neighbourhoods in between.



I have included this picture of the proposed Centennial College station as a reminder that the 7-stop LRT will go through its own corridor on trains that have the same top speed as a subway (80 km/h).



Unfortunately, the Mayor and some others have declared a "war" over this issue to justify the unjustifiable. They have falsely stated that those wanting a larger network of LRTs for Scarborough have delayed the process.

In fact, providing rapid transit to Scarborough has only been delayed by Council's flip flop from a fully-funded LRT to a 3-stop and then 1-stop subway. The changing and uncertain subway costs and plans are the reason the issue keeps coming back to Council. Assertions otherwise are disingenuous.

Another specious argument put forward by 1-stop subway proponents is that only a subway stop will stimulate economic development at STC. That is a falsely exclusive causal relationship. While a subway stop could help support growth at STC, so would an LRT line. The LRT would actually provide 2 stops in the projected growth precinct. That's one of the reasons why our Chief Planner previously stated that an LRT, rather than a subway, would better stimulate economic development, while also serving more low-income residents as well as students:


(If you are unable to access the video by clicking on the above picture, you can access it through this link)


Asking for the Facts

I have submitted several questions regarding transit options for Scarborough that need to be clarified before Council votes next week. It is very concerning that, at a council meeting last July, City Council may have been falsely led to believe that the LRT would take longer to build than it actually would. In addition, there are several basic questions remaining with regard to the 1-stop subway proposal's funding and ridership. Regardless of what transit plan Council chooses, it is important that the decision be made honestly and based on evidence rather than political interests.

I want Scarborough residents, along with all Torontonians, to have access to rapid transit to improve the quality of their lives.

I have included my full communication to the City Manager below for your review. It is also included in next week's City Council agenda:

March 21, 2017

City Manager's Office
11th Floor, East Tower, City Hall
100 Queen Street West
Toronto, ON M5H 2N2

Dear Mr. Wallace,

Questions Re: Transit Options for Scarborough

As you know, transit plans in Scarborough have gone through a number of iterations. A 7-stop, traffic-separated LRT was initially approved in 2007, and reconfirmed several times, including the "MOU Plan" between former Mayor Ford and Metrolinx, as shown in the March 31, 2011 Ontario government press release below:


Fig. 1


The project, along with 3 other LRT lines in Toronto, was reconfirmed on February 8, 2012 at a Special Meeting of Council.

The shift to a subway in Scarborough was first approved as a 3-stop subway in October of 2013 for $3.56 billion. The plan significantly changed on January 28, 2016 when Staff presented a 1-stop subway just to Scarborough Town Centre and a 17-stop eastern extension of the Eglinton Crosstown LRT for approximately the same funding as the previous 3-stop plan, as stated on page 3 of EX 11.5 – Scarborough Transit Planning Update:

"Initial estimates indicate it is possible to construct the extension of Line 2 and the Crosstown East for a similar order-of-magnitude cost and in a similar timeframe as the three-stop Scarborough Subway extension originally proposed."

Unfortunately, the estimated price of the subway, excluding financing and other costs, has risen by more than 50%, leaving the 17-stop Crosstown extension unfunded. At the upcoming Council meeting of March 28, 2017, Council will, for the first time, have an opportunity to decide whether to proceed with a 1-stop extension of the Bloor Danforth subway for $3.346 Billion as identified in EX 23.1 Next Steps on the Scarborough Subway Extension.

I am submitting the following questions as there are several significant matters pertaining to this item that require clarification before Council makes a decision on the future of transit in Scarborough.


Master Agreement

The Master Agreement between Metrolinx, the City of Toronto, and the TTC signed in 2012 stated that the Province would pay 100% of the capital costs associated with the Scarborough LRT as shown in the excerpt below from page 1 of Schedule G in the Master Agreement:


Fig. 2

Question: Is the Master Agreement between Metrolinx, the City of Toronto, and the TTC still valid?


Comparison

The business case analysis before Council only provides a relative comparison between two 1-stop subway options.

Question: Has the City ever provided a business case analysis that directly compared the subway extension (3 or 1-stop version) with the 7-stop LRT in Scarborough?


Transit Project Construction Issues

On July 4, 2016 a briefing note produced by the TTC (Attachment 1) appeared on CP24 regarding the possibility of moving forward with a 7-stop LRT from Kennedy to Sheppard, serving the existing RT route along with Centennial College and Sheppard. The contents of the briefing note were cited numerous times by Staff and Councillors during the Council meeting of July 12, 2016. This briefing note has still not been publicly posted on the website of the TTC or the City of Toronto.

The briefing note makes a number of assertions regarding the construction of the 7-stop LRT that require clarification prior to the upcoming Council meeting.

First, the briefing note assumes that the start of LRT construction would have to wait until work on the Eglinton Crosstown was completed at Kennedy. However, as the excerpt below from an April 25, 2012 Metrolinx Board Report states, Metrolinx was explicitly planning to start at the north end of the line first to speed up construction time:


Fig. 3

Question: Was the City/TTC aware of new information that would prohibit starting to build the Scarborough LRT at the north end of the line to expedite the construction process?

Further, an excerpt from page 1 of the same 2012 Metrolinx Board Report, shown below, states that, at the time, the Eglinton Crosstown was expected to be completed in 2020 and the Scarborough LRT's completion date was 2019:


Fig. 4


While the completion dates have changed, these construction timelines required that work occur simultaneously at Kennedy Station to facilitate both projects. As depicted in the diagram below, the Eglinton Crosstown was to occupy the below-grade platform, while the Scarborough LRT would enter at-grade.


Fig. 5


The briefing note states that, as a result of the Eglinton Crosstown, the Scarborough LRT is "physically precluded" at Kennedy Station without mentioning that space below-grade would now be available for the Scarborough LRT platform, further improving the transfer to the Bloor-Danforth subway.

Question: Is the City/TTC aware of a reason why Metrolinx would not be able to construct platforms at Kennedy Station for both the Eglinton Crosstown and the Scarborough LRT, as was originally planned, but with the platform levels for the two projects switched?


Design Completion

There have been several concerning inconsistencies regarding the stated level of design completion for both the 7-stop Scarborough LRT and the 1-stop subway that require clarification before Council votes later this month.

During the Questions to Staff portion of the debate on EX 16.1 Developing Toronto's Transit Network Plan to 2031 at the July 12, 2016 Council meeting, Councillor Colle asks the Deputy City Manager, Cluster B, a question on the design completion status of the Scarborough LRT (scroll to the 4hr:45min mark of this video to view):

Councillor Colle: "There's been a lot of discussion around, uh, the percentage of where we are, at design for various projects, and we were told recently for the, call it, 2008-9-10 LRT that that's at about 5 per cent design? Or it was at that time? Is that a fair number?"

DCM: "So, um, Madam Speaker, ah, we've had some discussions as a follow-up. Some elements are at 5 and some are at 10 per cent. That was the information we got from Metrolinx the other day."

The Deputy City Manager's response is seemingly at odds with the information presented by Metrolinx in the April 2012 Board Report included above (Fig. 3), which states that the longest portion of the line, between Kennedy and McCowan, was at 30% design completion.

Question: Did Metrolinx provide City Staff with information regarding the design completion status of the Scarborough LRT that contradicted their April 2012 Board Report, which claimed that the Kennedy to McCowan portion of the line was at the 30% design stage?

During the same question period, Councillor Colle asks a follow-up question about the design completion status of the 1-stop subway extension to Chief Project Manager for the Scarborough Subway Extension:

Councillor Colle: "And where would the subway be at design percentage of design completion? Around 5 (per cent) I think I've heard?"

Chief Project Manager: "Uh, we're currently at about 5 per cent, yes."

The Chief Project Manager's answer is reinforced by the chart below from the Staff report presented at the July 2016 Council meeting which states that the cost estimate provided was "developed at approximately 5% design":


Fig. 6


A similar chart included in the Staff Report before Council later this month states that the 1-stop subway extension is still at 5% design.

Question: Given that there has been significant work done on the 1-stop Scarborough Subway Extension between July 2016 and March 2017, why is the project design status not moved beyond the 5% completion status cited in July 2016?


Funding Source Issues

There are a number of unanswered questions regarding funding sources for the 1-stop Scarborough Subway Extension that require clarification prior to Council voting on the issue.

The chart below provides a breakdown of the funding sources for the subway extension:


Fig. 7


Recommendation 6 in the Staff report that contains the above chart reads:

City Council request the Province of Ontario and Government of Canada confirm the sources of funding for the provincial and federal commitments to the Scarborough Subway Extension.

The wording of this recommendation raises a number of questions regarding the degree to which Council can depend on the funding amounts indicated, including:

Question: Has the City determined whether the $660 million committed by the previous federal government will be considered a separate contribution under the Build Canada Fund or will the City have to apply for the project under phase 2 of the Investing in Canada Fund, thereby decreasing the amount of funds available through this program? Will the contribution be escalated under either funding source?

Question: Has the City determined whether the provincial government has agreed to the $1.99 billion escalated contribution cited in Fig. 7? Has the provincial government agreed to transfer the full contribution all at once?


Travel Patterns

One of the proposed main advantages of the 1-stop subway extension, in comparison to the original LRT plan, is the elimination of the transfer at Kennedy station. The main benefit of the elimination of the transfer is a faster travel time downtown. As shown below in the map from the 2011 Transportation Tomorrow Survey, downtown travel accounts for 23% of all transit trips that begin in Scarborough:


Fig. 8


Also evident in the map is that few riders from Scarborough get off the subway at destinations along the Bloor-Danforth line prior to the core.

As depicted in the rapid transit map below, it would appear that Scarborough commuters going downtown would have a much faster ride on SmartTrack/GO RER.


Fig. 9


Question:
How many riders during the AM peak and throughout the day are predicted to transfer to and from SmartTrack/GO RER at Kennedy Station?

Thank you for your attention in these matters. I look forward to responses that provide me and my colleagues with adequate time to review.


Sincerely,



Josh Matlow
Toronto City Councillor
Ward 22- St. Paul's



----------------------------------------------------------------------



Attachment 1



Briefing Note
Date: June 29, 2016

Issues Relating to Re-introduction of LRT Replacement for Line 3 (SRT)
Background
The original proposal - to replace the aging Line 3 Scarborough (SRT) with a 7-stop LRT line, extending to Sheppard Avenue East, is shown in the attached schematic.  This note summarises the primary tasks that would have to be undertaken in the event that the LRT solution was re-introduced. It is intended to assist in the event of any questions on this matter at City Council. It is important to note that these figures are estimates only and have been escalated, as noted below.

Discussion
The Environmental Assessment (EA) that was approved for the LRT project in 2010 must be updated, and formally amended, to address the following elements:

  1. Complete Redesign of the EA-Approved LRT Connection at Kennedy Station:  The most complex aspect of the conceptual design work on the LRT was the connection at Kennedy Station.  The recommended solution, shown in the attachments in plan and cross-section views, consisted of a large one-way LRT loop with the LRT station directly on top of the Eglinton Crosstown LRT (ECLRT) station. As Metrolinx’s plans for the ECLRT were finalised after Council approved subway technology in October 2013, they did not make any provision to protect for the LRT connection. This LRT connection is now physically precluded by the current ECLRT plans and an entirely new design would have to be developed.
  1. New Ridership Forecasts: As with the subway extension, ridership forecasts for the LRT would have to be updated using the City’s new forecasting model and reflect changes in the transit network in Scarborough.  This would include Smart Track/RER - with several options re service frequency and assumed level of fare integration – and options with and without the Sheppard East LRT and the easterly extension of the ECLRT.
  1. Review Potential Conflicts with GO/RER: A new design concept for a Lawrence LRT station must be developed that incorporates the current plans for a Smart Track Station at Lawrence Avenue.  In addition to identifying and resolving any issues at Lawrence Station, the LRT plans would have to reviewed with Metrolinx to  and identify and resolve any conflicts as the running structure is in the same corridor.
  1. Assess LRT Maintenance and Storage Facility (MSF) Options:  Subject to confirmation of a consistent maintenance/operating/ownership model for three LRT lines in Scarborough, an adequate location for MSF facility would have to be identified.  This could mean an interim solution (eg. a Bellamy yard was included in the original LRT EA) with a future consolidation at the previously planned Sheppard/Conlins yard.
  1. Closure of Line 3: finalise plans for the bus replacement service when Line 3 is shut down, including the associated temporary bus terminals and storage facility.
  1. Re-examine Bus Terminal Concepts at Stations: The previous number of bus bays to be confirmed for all stations.


vii)        Update Schedule and Capital Cost

viii)       EA Amendment Public Meeting: It is expected that at least one public meeting would be necessary as part of the process to amend the LRT EA.

Timing
From the point Council directs staff to proceed with an LRT solution, a very rough estimate would be that it would take approximately 12 to 18 months to present a revised plan to obtain Council and MOE approval. This is very much dependent upon the time required to identify, and obtain acceptance of, a new connection at Kennedy Station.

The construction at Kennedy Station is the key element on the critical path for the LRT and depending if the preferred design is above or below grade, construction could range from approximately 3.5 to 5 years.  If staff are directed to proceed in July 2016 and assuming construction cannot begin before the ECLRT work at Kennedy is completed in 2021, a quick preliminary evaluation suggests the LRT could be operational in early 2026 to late 2027.

Funding
With the change in technology, confirmation of contributions from funding partners may be required.

Order of Magnitude Comparison

The October 2013 Council report indicated the Province had announced $1.8B ($2010) for construction of SRT as LRT, to Sheppard. Of the $1.8B, the Province committed $1.48B ($2010) to the SSE.  As a minimum, staff believe the $1.8B should be the starting point, which would have to be updated through proper design to address the changes noted above.
The $1.48B has recently been reported as the total cost of a seven stop LRT.  To facilitate a high level cost comparison of the current subway estimate to the costs of an LRT at this time, the $1.8B was escalated to an end of 2025 opening (2% per year from 2011 to 2013 and 4% per year from 2014 to mid-2023), adding SRT Life Extension and SRT Shutdown service.

$1.8B escalated                                                      $2.7B
SRT Life Extension                                             .108
SRT Shutdown                                                  .171
Total                                                                 $2.979B
Prepared By
Rick Thompson, Chief Project Manager, Scarborough Subway Extension
416-590-6870



City Hall and Community Update for February 24, 2017

The Yonge & St. Clair Valentine's Day Fire at the Badminton & Racquet Club

The term “hero” is sometimes used too easily but I can’t think of a better word to describe the Fire, Police and EMS responders who attended to the 6-alarm fire at Yonge & St. Clair last week. For more than 24 hours, over 100 firefighters worked long, dangerous and grueling shifts to put out the blaze at the Badminton and Racquet Club; keeping the fire from spreading to residential buildings only feet away. In an amazing display of teamwork, Toronto Fire Services was joined by Police, EMS, the Office of Emergency Management, Toronto Hydro, Toronto Water, TTC, and others.

I would also like to commend Slate Asset Management for offering us the lobby of 55 St. Clair Ave West as a reception centre run by the Red Cross for displaced residents from buildings such as The Clairmont at 1430 Yonge Street and many others, as well as Tim Horton’s for staying open over night to provide refreshments. I'm also very appreciative of the many members of our community who offered a spare bedroom and other supports to their neighbours who were evacuated.

I have reached out to the President of the Badminton and Racquet Club, whose members lost a place that was very close to their hearts, to express our community’s sadness and strong support as they move forward. The B & R Club was also a building of historical importance to every resident of Toronto. An early example of of an adaptive reuse of a historic building, (it was a radial car barn (like Wychwood Barns) the club opened in 1925.

Impending Loss of 1955 Yonge Street

As many in the Davisville and Chaplin Estates neighbourhoods will already know, a developmentwas approved by a previous Council, in August 2010 at 1955 Yonge Street between Belsize and Millwood. Unfortunately, a property on this block (currently acting as the developer’s sales office) was not recognized as potentially having heritage value before the development was approved. City Heritage Staff has sadly informed me that there is nothing we can do to save the building.

For commercial reasons, the developer has not taken steps to move forward with construction until recently. The Buildings Department has informed me that the developer recently requested a demolition permit for this site and that they are legally bound to issue that permit shortly.

To help ensure that our community is able to protect more buildings of cultural and historical significance, City Planning is conducting a heritage audit of our community as part of theMidtown in Focus review of the Yonge-Eglinton Secondary Plan Area I requested. The results of this review are expected this year.

For your convenience, I have created an interactive map of all heritage properties located in Ward 22. Also, please click here to read the comments I wrote in my last update to you about the importance of Toronto's architectural heritage.

The Toronto Star Feature Series on the OMB and our Yonge-Eglinton Area

The Ontario Municipal Board (OMB) is an unaccountable, unelected and anti-democratic provincially-appointed body that has the final say over our city's planning decisions. The influence that the OMB has had on the Yonge-Eglinton area were featured in a well-written, informative series in the Toronto Star this past weekend.

As many of you know, I have been a long-time advocate of freeing Toronto from the OMB’s purview. While the Province has stopped short of eliminating the OMB altogether, there are a number of very positive reforms proposed in this Ministry of Municipal Affairs consultation document released last year that would significantly improve the planning process for Toronto, including:
  • Only allowing the OMB to hear appeals on the “validity of the decision” by council, limiting the OMB’s ability to hear appeals and completely overturn decisions
  • Preventing appeals of secondary plans, including Yonge and Eglinton which is now under review, for two years
  • Requiring the OMB to send “significant new information” arising from a hearing back to council for re-evaluation before rendering a decision
  • More actively promoting mediation to settle disputes, preventing adversarial hearings
  • Better training for OMB members, who are appointed by the Province
It is expected that the Province will move forward with legislation this year. I will be sure to update you as this important review progresses and new information is available.

City Staff to Defend Community at OMB Against Yonge & St. Clair Development

At Toronto and East York Community Council this week, my colleagues supported my motion to ensure the neighbourhood will be represented by City Planning and City Legal to oppose the inappropriate development proposal at 1417-1431 Yonge Street, just south of St. Clair.

This file has had a long history and several iterations. On November 24, 2015, the applicant appealed City Planning’s refusal of their application for a 42-storey building to the Ontario Municipal Board (OMB). On August 2, 2016 at an OMB pre-hearing, the applicant informed the Board of a revised proposal for its site. Completely ignoring the community, the new proposal is for 46 storeys.

While I strongly agree that the Yonge & St. Clair area is in need of revitalization, this specific development proposal is inappropriate from functional and aesthetic perspectives. City Planning Staff have stated that the building is too tall and dense for the site, leaving very little room on the sidewalk and no additional public space, which is typical for a building of this size. As well, this condo would put added stress on the already overcrowded rear laneway. There is even concern that delivery vehicles, taxis, cars, and other vehicles accessing the proposed site could interfere with the St. Clair streetcar where it turns into the station.

The OMB hearing is scheduled for June of this year.

REMINDER: Let's Design Ward 22's Two New Park Spaces Together: Second Public Meeting

In early December 2016, I held an initial public meeting to gather residents' feedback on potential designs and uses for our two new parks on Manor Road East that we fought for together (the former Glebe Manor Lawn Bowling Club site and the corner of Manor Road and Forman Avenue). Since that meeting, the project design consultant has been busy developing design concepts based on that feedback and will be ready to share these drawings with the community shortly.

Please join me and your neighbours on Monday, February 27 to review and comment upon these concept designs for our two new parks! The meeting will be held at 6:30pm in the newly renovated sanctuary at Manor Road United Church (adjacent to one of our new park spaces at 240 Manor Road East). City of Toronto Parks staff will also be in attendance.

Independent Toronto Airspace Noise Review Public Meeting

In early 2012, NAV Canada changed the flight patterns of aircraft approaching and leaving Toronto Pearson International Airport. Many residents have contacted me and reported disturbances from increased air traffic noise including during overnight hours. Some have described the noise as living under an "air super-highway" and find the volume and frequency of flights intolerable.

I brought a motion to City Council to have City of Toronto officials meet with representatives from NAV Canada, the federal Ministry of Transportation, and other relevant bodies to find a less intrusive flight path that respects the needs of Toronto residents to live without excessive noise pollution. I continue to work together with the Toronto Aviation Noise Group (TANG) to advocate for the Federal government to address these concerns directly.

Next month, there will be an opportunity for you to have your voice heard on this issue. HELIOS, the UK-based aviation consulting company hired by NAV CANADA to conduct the independent Toronto Airspace Review, has scheduled the next round of public consultation meetings for early March.

The meeting date with the location closest to most mid-town Toronto residents is:

Saturday, March 4, 2017
10:30am to 12:30pm
Novotel North York
3 Park Home Avenue
North York
M2N 6L3

For more information, please click here.

Time for Torontonians to Get Ready to Register for Spring/Summer Recreation Programs

The City of Toronto offers recreation programs for all ages, skill levels and interests. Registration for spring and summer general programs, spring skating and swimming, and summer camps begins in two weeks.

Registration dates
Registration is by district and starts at 7am on each date:
Etobicoke York: Saturday, March 4
Scarborough: Sunday, March 5
North York: Tuesday, March 7
Toronto and East York: Wednesday, March 8

Residents should visit http://www.toronto.ca/torontofun before registration day to build wish lists (program titles and bar codes) and have a few options ready in case they don’t get their first choice.

Those who want to register for programs will need to set up an account. Residents can call 416-338-4386, email  This e-mail address is being protected from spambots. You need JavaScript enabled to view it or speak with staff at a City community centre to get a family number and a client number.

Parks, Forestry and Recreation will offer extended customer service call centre hours on March 1, 2, 3 and 6 from 7:30am to 6:30pm to assist with account information and answer questions about registration for spring/summer programs.


Welcome Policy yearly credit
The Welcome Policy credit can be used to register for City recreation programs. People receiving social assistance (Ontario Works) and living in Toronto are pre-approved to receive this credit and should speak to their caseworker. You can visit http://www.toronto.ca/wp for more information about the yearly credit.

Free programs
Many community centres offer free recreation programs including leisure swimming and skating, and drop-in programs for children, youth and older adults. More information about free and low-cost programming options is available here.

Older adult discounts
Older adults (60 plus years) who register for adult recreation programs receive a 50 per cent discount off the regular price of those programs.

Access to Art Programs and Workshops - Seniors Arts Engagement Program

The AGO invites visitors of all abilities to experience our collections in an inclusive and welcoming environment.

Make the AGO yours and discover your creativity!
  • Creativity is proven to support emotional well-being
  • Creativity reinforces the brain cells responsible for memory
  • Creativity cultivates a positive approach to life that enhances the immune system
  • Creativity promotes social interactions that help combat depression

Seniors Community Grant Program

The Seniors Community Grant Program, the first grant program in Ontario dedicated solely to seniors, is designed to give our elder population more opportunities to participate in their communities by providing funding to not-for-profit community groups for projects that encourage greater social inclusion, volunteerism and community engagement for seniors.

This grant program will make $2 million available for projects across Ontario that will help more seniors become socially engaged and feel part of their communities. Grants range from $1000 to $8000.

For your convenience, here are the program guidelines and application form.

For more information:
Applications will be accepted between November 25, 2016 and March 3, 2017.

Projects must not start prior to June 15, 2017 and be completed by March 31, 2018.

New Green Bins Arrive in Ward 22 Soon

The City continues to phase in delivery of the new Green Bins and the neighbourhoods in the northern part of District 3, east of Yonge Street and west of Victoria Park Avenue, will start receiving their new bins beginning March 9. It will take about three months to complete this distribution. The City will deliver to one collection route per day, which represents approximately 1,500 households. On the same day that residents get their new Green Bin, the old one will be taken away and recycled. If collection crews miss removing your old bin that day, set it out EMPTY on your next collection cycle and it will be picked up then (those who miss this second opportunity may contact 311 to arrange removal).

Here are some of the New Green Bin's key features:
  • It is animal-resistant so it can be stored outside or placed at the curb the night before collection with the lid in the locked position
  • It is larger and can hold more organics; plus, it meets automated collection requirements
  • Set out is important. Place the bin with the dial in the locked position with the arrows on the top of the lid facing the street to receive collection and please remember to leave space (0.5 metres) between bins for automated collection
More tips on using your new bin will be delivered with the bin. It is important to start using your new bin on your next collection day, as the City will no longer be able to collect from the old one.

You can check the bin delivery progress in our area on the City's Solid Waste Management webpage at www.toronto.ca/greenbin. These maps are updated weekly and are a useful tool to refer to if you have inquiries on the delivery status of the new Green Bins.

For questions or concerns about your new Green Bin, or to order an additional one, please contact 311.

Updated Ward 22 Development Page

To ensure you are informed and engaged about development proposals being proposed for sites near your neighbourhood, I've created an interactive webpage

My webpage listing all the proposed developments in Ward 22 has recently been updated to reflect current development applications and, as always, contains locations, staff reports and public meeting notices. Additionally, the map now shows the boundaries of the Urban Growth Centre surrounding Yonge and Eglinton, as well as the designated Avenues (portions of Eglinton Avenue West, St. Clair Avenue West, Yonge Street, Mt. Pleasant Road and Bayview Avenue). These are all areas where the Province is directing growth. Clicking on any of them will provide links to more information about the ward's Avenues/Urban Growth Centre, as well as links to the City's Official Plan and local secondary plans.
For ongoing council and community news, my contact information, along with a calendar of events, please visit www.joshmatlow.caClick here to read my previous city hall and community updates.


City Hall and Community Update for February 3rd 2017

Toronto’s Heritage Protection Policies Must Be Strengthened

Toronto has a shameful record when it comes to protecting its architectural heritage.

The wanton demolition of the Bank of Montreal building at 2444 Yonge Street last month, and the Stollery's Building at Yonge and Bloor in January 2015, are just two of the most recent examples of the City's inability to stay ahead of development applications. We need to implement a more proactive mechanism to protect better protect Toronto's built heritage before. That's why I moved a motion in 2015 to strengthen our heritage policy framework.

Currently, for a building to have protection, it must be either “listed” or “designated” under the Ontario Heritage Act (OHA). A very lengthy process is required for a property to become listed, including a full evaluation and completed Staff research report, followed by consideration by both Community Council and City Council. Only following City Council approval does a property become eligible for protection under the OHA, including demolition protections under the Ontario Planning Act. This review process can take up to five months to complete for a single property. For a property to become fully designated, the process can take up to eight months. There is nothing to save a heritage property from the wrecking ball while this process is taking place.

My motion asked City Planning staff to report back to Planning and Growth Management Committee on the feasibility of establishing a new tier of heritage designation that is more inclusive, proactive and expeditious. This new category would protect properties that have been identified but not yet evaluated for listing or designation.

We are still waiting on the Chief Planner to take action on this Council direction.

You can read more about the current challenges facing the City's heritage policy and my efforts to improve them in this article.

Also, for your convenience, I have created an interactive map of all heritage properties located in Ward 22.


City Staff Proposing Massive Fee Hikes for Patios

Small business owners across the city are sounding the alarm over a proposal from Licensing and Standards Staff that would see fees for some patios increase by over 1000%. While some adjustment might be reasonable, I will not support any measure that provides a disincentive for business owners to provide outdoor seating in appropriate locations.

Patios contribute to more fun and vibrant streets, our local economy and community residents' quality of life. Where residential neighbors aren't adversely impacted, the City should be working to encourage more patios instead of making them prohibitively expensive.

For more information on this issue, please read this article.


REMINDER: Community Skating Party with Josh Matlow, Rob Oliphant & Carolyn Bennett!

I'm excited to be co-hosting a community skating party with our local MPs, Rob Oliphant and Carolyn Bennett at Hodgson Ice Rink (East of Mt. Pleasant, entrance off Millwood/Harwood, behind Hodgson PS).

Please join us from 2pm to 4pm on Sunday, February 12th for a fun, family-friendly afternoon with free coffee and hot chocolate.

I look forward to seeing you there!


REMINDER: Councillor Josh Matlow's 2017 City of Toronto Budget Town Hall Meeting

On Wednesday, February 8th at 7pm, I will be hosting my 2017 Budget Town Hall for Ward 22 residents at Christ Church Deer Park, Elliott Hall, 1570 Yonge Street.

The City of Toronto's budget will affect virtually every City service and your feedback is very important to me. I hope you will be able to attend.

If you would like more information on the proposed 2017 City of Toronto Budget in advance of my Town Hall meeting, please click here.


REMINDER: Let's Design Ward 22's Two New Park Spaces Together: Second Public Meeting

In early December 2016, I held an initial public meeting to gather residents' feedback on potential designs and uses for our two new parks on Manor Road East that we fought for together (the former Glebe Manor Lawn Bowling Club site and the corner of Manor Road and Forman Avenue). Since that meeting, the project design consultant has been busy developing design concepts based on that feedback and will be ready to share these drawings with the community shortly.

Please join me and your neighbours on Monday, February 27 to review and comment upon these concept designs for our two new parks! The meeting will be held at 6:30pm in the newly renovated sanctuary at Manor Road United Church (adjacent to one of our new park spaces at 240 Manor Road East). City of Toronto Parks staff will also be in attendance.


Midtown in Focus Study Continues

As part of our Midtown in Focus study, the City of Toronto is developing an area-wide vision for parks and public spaces in the Yonge-Davisville area. As a follow up to a successful workshop in the fall, myself and City Planning Staff are reconvening for another public meeting at 7pm on Wednesday, February 22nd at Northern District Library (40 Orchard View Boulevard). We would be pleased to hear your feedback and ideas on creating a safer and more vibrant public realm in the community!

If you have any questions please feel welcome to contact myself or the City Planner Paul Farish at 416-392-3529 or  This e-mail address is being protected from spambots. You need JavaScript enabled to view it


Updated Ward 22 Development Page

To ensure you are informed and engaged about developments being proposed for sites near your neighbourhood, I've created an interactive webpage

My webpage listing all the proposed developments in Ward 22 has recently been updated to reflect current development applications and, as always, contains locations, staff reports and public meeting notices. Additionally, the map now shows the boundaries of the Urban Growth Centre surrounding Yonge and Eglinton, as well as the designated Avenues (portions of Eglinton Avenue West, St. Clair Avenue West, Yonge Street, Mt. Pleasant Road and Bayview Avenue). These are all areas where the Province is directing growth. Clicking on any of them will provide links to more information about the ward's Avenues/Urban Growth Centre, as well as links to the City's Official Plan and local secondary plans.



Please click here to learn more about what you can do to help free Toronto from the Ontario Municipal Board (OMB).




Page 1 of 50

Subscribe to my City Hall and Community Updates

Here are my previous e-newsletters.

Stay up to date on the latest Ward 22 news and events by subscribing to our e-newsletter.

* indicates required

Josh On Twitter
